Introduction
Hot-weather concreting is not simply a problem of high air temperature.
Concrete performance during hot weather is affected by the combined influence of:
- ambient temperature;
- fresh-concrete temperature;
- solar radiation;
- wind velocity;
- relative humidity;
- transport time;
- waiting time;
- material temperatures.
In hot conditions, concrete may experience:
- faster slump loss;
- increased water demand;
- accelerated setting;
- reduced finishing time;
- difficulty in pumping and placing;
- increased risk of plastic shrinkage cracking;
- reduced later-age performance if uncontrolled water is added.
The correct approach is:
Mix Design + Temperature Control + Moisture Correction + Admixture Selection + Slump-Retention Trial + Transport Planning + Early Curing
For batching-plant cooling measures, see Concrete Temperature Control at Batching Plant.

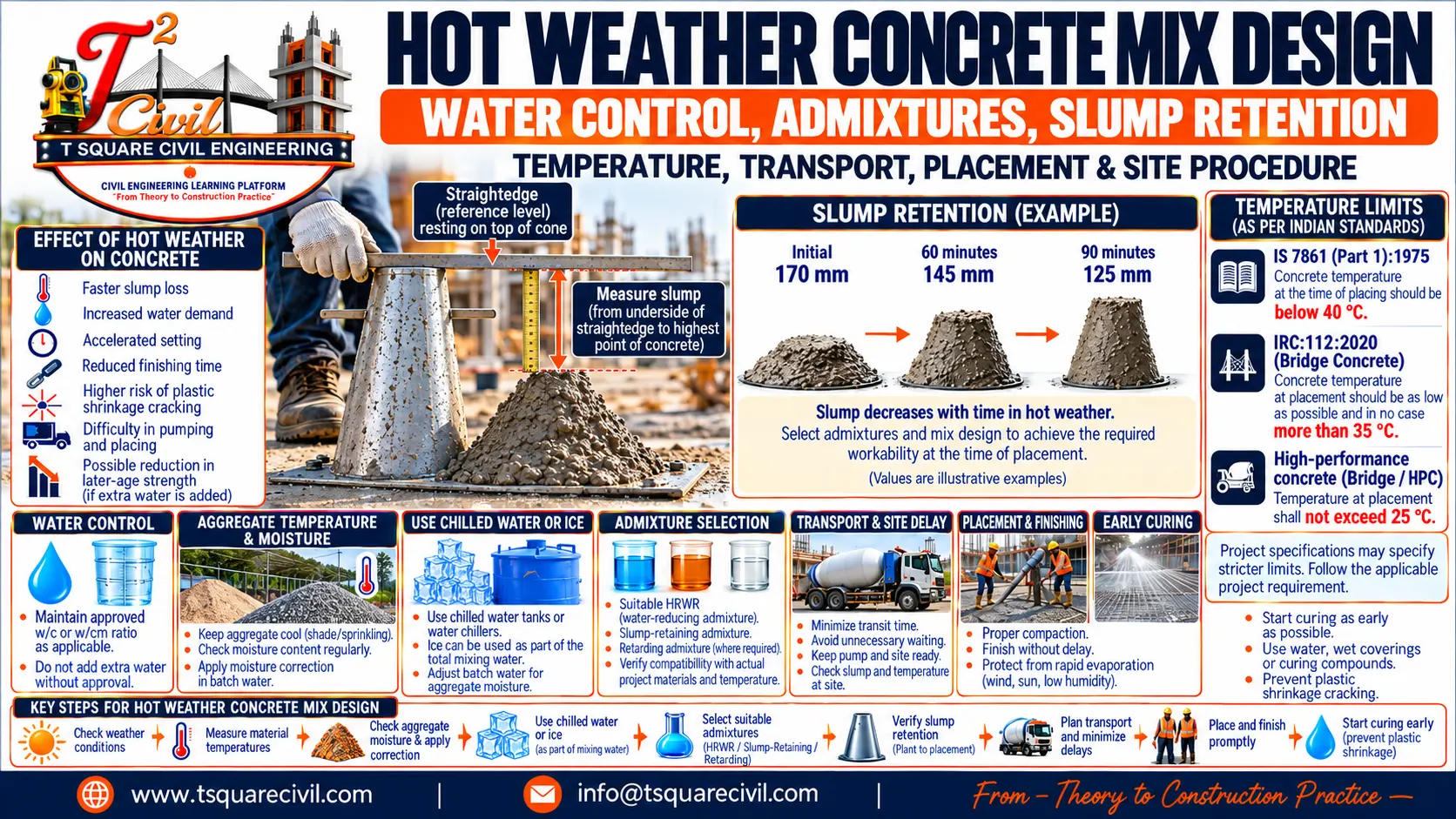

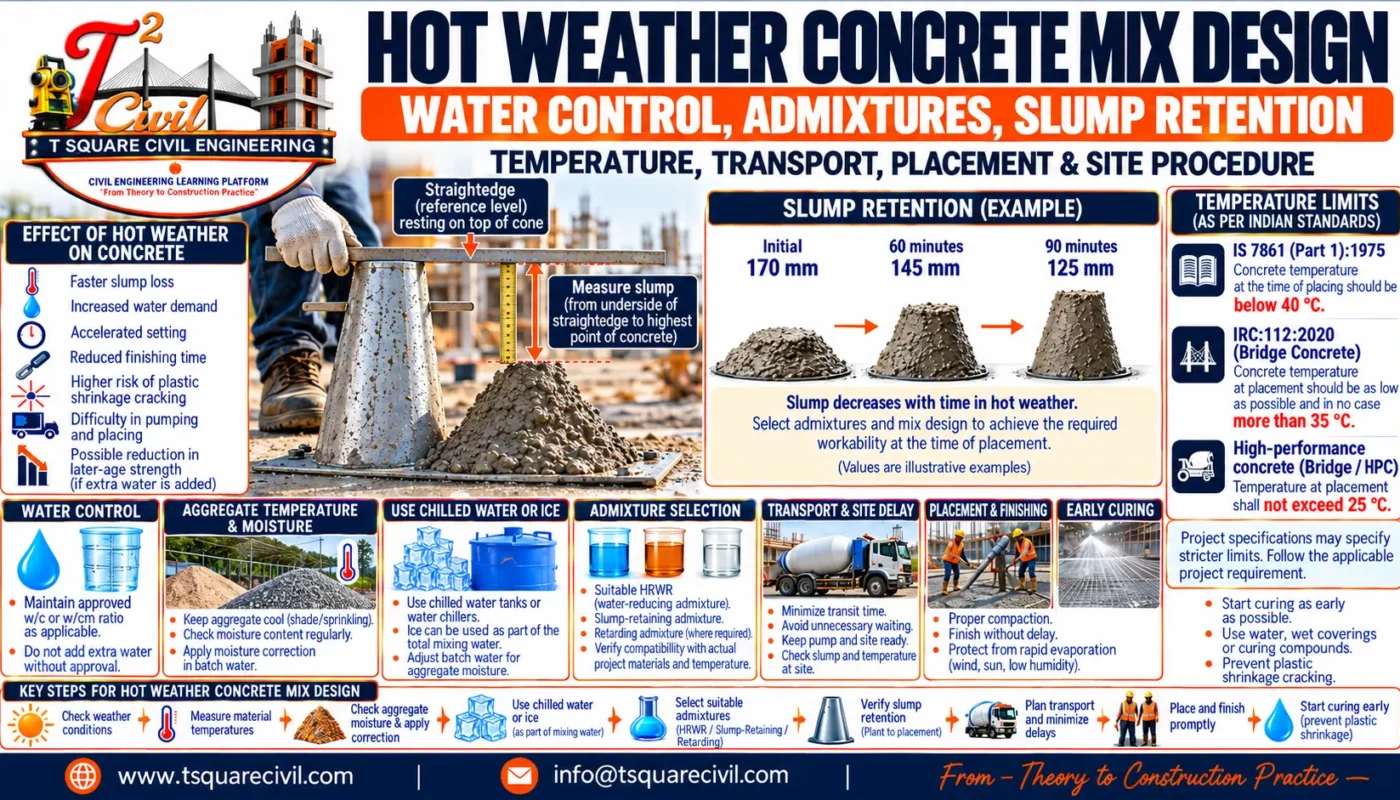

What Is Hot-Weather Concreting?
Hot-weather concreting means producing, transporting, placing and finishing concrete under environmental conditions that may adversely affect fresh or hardened concrete.
The problem is not controlled by air temperature alone.
For example:
High Temperature + Low Relative Humidity + Strong Wind
may create a more severe concreting condition than:
High Temperature + High Relative Humidity + Low Wind
because evaporation from the fresh-concrete surface can be much higher.
Indian Standard for Hot-Weather Concreting
The principal Indian Standard for hot-weather concreting is:
IS 7861 (Part 1):1975 — Code of Practice for Extreme Weather Concreting: Part 1 Recommended Practice for Hot Weather Concreting
IS 7861 (Part 1) provides guidance on:
- selection and cooling of concrete ingredients;
- concrete temperature;
- admixture use;
- transportation;
- placing;
- protection;
- curing.
The standard recommends that, where necessary, the ingredients should be cooled sufficiently so that the concrete temperature at the time of placing remains below 40°C.
However, this does not mean 40°C is acceptable for every project.
Metro, bridge, high-performance concrete and other major infrastructure projects may specify lower limits.
Therefore:
Applicable Project Specification → Governing Code → General Guidance
The stricter applicable requirement should be followed.
Hot Weather Does Not Mean a Different Concrete Grade
Hot weather does not normally change the specified concrete grade.
For example, M30 concrete remains M30 concrete.
What changes is the way the concrete is:
- proportioned;
- trialled;
- cooled;
- transported;
- placed;
- cured.
Hot-weather mix design is therefore mainly about maintaining the required performance of the approved mix under more demanding environmental conditions.

Main Effects of Hot Weather on Concrete
Faster Slump Loss
Higher concrete temperature generally increases the rate of:
- hydration;
- stiffening;
- evaporation.
As a result, concrete may have satisfactory workability at the batching plant but arrive at site with significantly lower slump.
For detailed explanation, see Slump Loss in Concrete.
Increased Water Demand
Hot aggregates and high concrete temperature may make concrete appear stiffer.
The wrong response is uncontrolled water addition.
Increasing water may increase:
- water-cement ratio;
- permeability;
- bleeding;
- shrinkage;
and may reduce:
- strength;
- durability.
Faster Setting
Higher concrete temperature may accelerate setting.
This reduces the available time for:
- transport;
- pumping;
- placing;
- compaction;
- finishing.
Plastic Shrinkage Risk
Plastic shrinkage can occur when water evaporates rapidly from the concrete surface before sufficient strength develops.
Risk increases with:
- high concrete temperature;
- high air temperature;
- low humidity;
- strong wind.
Reduced Construction Time Window
During hot weather, concrete may remain suitable for placement for a shorter period.
This becomes especially important for:
- ready-mixed concrete;
- long transport distances;
- high-rise pumping;
- raft foundations;
- congested reinforcement;
- large continuous pours.
Water-Cement Ratio Must Remain Controlled
Hot weather does not justify increasing the approved water-cement ratio.
Suppose an approved concrete mix has:
w/c = 0.42
The site should not increase it arbitrarily to:
w/c = 0.47
simply because the concrete has become less workable.
Instead, investigate:
- concrete temperature;
- aggregate moisture;
- admixture dosage;
- transport duration;
- waiting time;
- batching accuracy.
See Water–Cement Ratio in Concrete.
Control the Effective Water Content
The important parameter is not only the water added through the batching system.
The effective water in concrete also depends on:
- aggregate free moisture;
- aggregate absorption;
- added water;
- ice used as mixing water;
- moisture introduced during aggregate cooling.
Therefore, hot-weather production requires accurate moisture correction.
See Moisture Correction in Concrete Mix Design.
Example – Moisture Correction
Suppose the approved mix requires:
Effective water = 170 kg/m³
Water contributed by fine aggregate moisture:
12 kg/m³
Water contributed by coarse aggregate moisture:
4 kg/m³
Then the water to be added through the batching system is:
170 − 12 − 4 = 154 kg/m³
If the aggregate is sprinkled for cooling and its moisture increases, the correction must be recalculated.
Therefore:
Aggregate Cooling + Moisture Testing + Water Correction
should be treated as one operation.
Aggregate Temperature
Aggregates normally make up the largest proportion of concrete by mass.
Therefore, aggregate temperature can significantly influence fresh-concrete temperature.
Possible control measures include:
- shaded stockpiles;
- covered storage;
- controlled sprinkling;
- chilled-water cooling;
- production during cooler hours.
For detailed plant controls, see Concrete Temperature Control at Batching Plant.
Mixing Water Temperature
Cooling mixing water can effectively reduce fresh-concrete temperature.
Possible systems include:
- chilled-water tanks;
- water chillers;
- insulated storage tanks;
- recirculation systems.
The required water temperature should be based on:
- actual material temperatures;
- target concrete temperature;
- plant trials.
Use of Ice in Hot-Weather Concrete
Where additional cooling is required, part of the mixing water may be introduced as ice.
An important rule is:
Ice is part of the total mixing-water quantity.
For example, if the approved total mixing water is:
170 kg/m³
and:
30 kg/m³ of ice
is used, the remaining liquid water is approximately:
170 − 30 = 140 kg/m³
subject to the complete moisture correction for aggregates.
Ice should melt completely during mixing.
Unmelted ice may create:
- non-uniform water distribution;
- local variation in w/c ratio;
- inconsistent concrete.
Concrete Temperature
IS 7861 (Part 1):1975 recommends cooling the ingredients where necessary so that concrete temperature at the time of placing is below 40°C.
However, lower project limits may apply.
For example, major infrastructure projects may prescribe stricter placing-temperature requirements.
Therefore:
40°C is general IS 7861 hot-weather guidance, not a universal project acceptance limit.
Always verify:
- project specifications;
- approved method statement;
- contract requirements;
- applicable bridge, metro or special-concrete requirements.
Plant Temperature vs Placement Temperature
Concrete temperature should not be controlled only at the batching plant.
Temperature may change during:
- transport;
- waiting;
- pumping;
- placement.
Therefore, the plant dispatch target may need to be lower than the specified maximum placement temperature.
Example
Suppose:
Maximum permitted placement temperature = 30°C
Expected increase during transport and waiting:
1.5°C
A practical plant target may be approximately:
30 − 1.5 = 28.5°C
The actual target should be established through field trials and monitoring.
Chemical Admixtures in Hot Weather
Chemical admixtures can play an important role in hot-weather concrete.
Depending on the concrete and project requirements, they may assist with:
- water reduction;
- slump retention;
- setting-time control;
- pumpability.
Admixture performance should be verified using the actual:
- cement;
- SCM;
- aggregate;
- water;
- temperature;
- transport time.
See Superplasticizer in Concrete Mix Design.
Water-Reducing and Set-Retarding Admixtures
IS 7861 recognizes that high temperature may increase mixing-water demand and reduce workability.
Where appropriate, suitable water-reducing and set-retarding admixtures may be used to offset these effects.
However, admixtures should not be selected only from the product label.
Their suitability should be confirmed by:
- technical evaluation;
- compatibility testing;
- concrete trials.
Slump-Retaining Admixtures
A high initial slump does not necessarily mean good slump retention.
Consider two trial mixes.
Mix A
Initial slump:
180 mm
Slump after 90 minutes:
90 mm
Mix B
Initial slump:
160 mm
Slump after 90 minutes:
130 mm
If the concrete needs to be placed after approximately 90 minutes, Mix B may provide better workability retention despite having a lower initial slump.
Therefore:
Initial Slump ≠ Slump Retention
The target should be:
Required Workability at the Actual Point and Time of Placement
Retarding Admixtures
Where technically suitable, a retarding admixture can increase the available working time during hot weather.
It may help with:
- long transport;
- large pours;
- pumping;
- delayed finishing.
However, excessive retardation may cause:
- delayed setting;
- delayed finishing;
- prolonged bleeding;
- delayed early strength.
Dosage should therefore be established through trials.
Cement–Admixture Compatibility
Admixture performance can change significantly with cement characteristics.
Hot weather may make compatibility problems more visible.
Possible symptoms include:
- rapid slump loss;
- abnormal stiffening;
- poor retention;
- excessive retardation.
See Cement–Admixture Compatibility in Concrete Mix Design.
Supplementary Cementitious Materials
Supplementary cementitious materials such as:
- fly ash;
- GGBS;
- silica fume;
may affect:
- workability;
- heat development;
- setting;
- strength development;
- admixture demand.
Their effect depends on the complete concrete system.
Therefore, SCM selection and replacement level should be based on:
- performance requirements;
- applicable standards;
- mix trials.
Do not assume that one SCM automatically solves hot-weather problems.
Concrete Grade and Binder Content
High binder content may increase:
- heat generation;
- paste volume;
- admixture demand.
High-strength mixes may therefore require particularly careful hot-weather control.
The concrete should be optimized for:
- strength;
- durability;
- workability;
- temperature;
- slump retention;
rather than simply increasing cement content.
Hot-Weather Trial Mix Procedure
Hot-weather concrete should be evaluated under conditions representative of actual production and transport.
Step 1 – Use Actual Project Materials
Use the actual:
- cement;
- SCM;
- fine aggregate;
- coarse aggregate;
- admixture;
- water.
Step 2 – Record Environmental Conditions
Record:
- ambient temperature;
- relative humidity where relevant;
- wind conditions where relevant.
Step 3 – Record Material Temperatures
Record:
- cement temperature;
- aggregate temperature;
- water temperature.
Step 4 – Check Aggregate Moisture
Determine the actual moisture condition and make the required water correction.
Step 5 – Prepare the Trial Batch
Produce concrete using the approved proportions.
Step 6 – Measure Fresh-Concrete Temperature
Measure and record the temperature immediately after mixing.
Step 7 – Measure Initial Workability
Record:
- slump;
or another applicable workability parameter.
Step 8 – Simulate Transport Conditions
Keep the concrete under controlled conditions representing actual delivery and handling as closely as practical.
Step 9 – Repeat Workability Measurements
Possible trial intervals include:
- initial;
- 30 minutes;
- 60 minutes;
- 90 minutes;
- 120 minutes.
These are practical trial intervals, not universal mandatory code intervals.
Step 10 – Observe Concrete Behaviour
Check for:
- segregation;
- bleeding;
- stickiness;
- harshness;
- cohesion;
- pumpability.
Step 11 – Check Setting Behaviour
Confirm that the admixture system does not cause unacceptable:
- rapid setting;
- excessive retardation.
Step 12 – Verify Strength
Verify:
- 7-day strength;
- 28-day strength;
- project-specific requirements.
Example – Slump-Retention Trial
Suppose the trial results are:
| Time After Mixing | Slump |
|---|---|
| Initial | 170 mm |
| 30 minutes | 160 mm |
| 60 minutes | 145 mm |
| 90 minutes | 125 mm |
Suppose required workability at placement is:
120 ± 25 mm
and expected placement is approximately 90 minutes after batching.
The trial indicates that the concrete may retain suitable workability at the expected placement time.
However, approval should also consider:
- segregation;
- bleeding;
- temperature;
- setting;
- strength;
- project requirements.
This is an illustrative example only.
Do Not Arbitrarily Increase the Initial Slump
A common response to hot-weather slump loss is to increase the plant slump excessively.
This may create:
- segregation;
- bleeding;
- instability.
The preferred approach is to improve:
- temperature control;
- admixture performance;
- moisture correction;
- transport planning.
Transport Time
Transport duration becomes more important in hot weather.
Planning should consider:
- haul distance;
- traffic;
- route conditions;
- batching capacity;
- site access.
Concrete should not remain unnecessarily in transit.
Waiting Time at Site
Even after reaching the project site, concrete may continue losing workability.
Typical reasons include:
- pump breakdown;
- reinforcement inspection;
- formwork delay;
- crane unavailability;
- blocked access.
Therefore, before dispatch:
Plant Ready + Truck Ready + Pump Ready + Site Ready
should be coordinated.
Ready-Mixed Concrete in Hot Weather
Ready-mixed concrete production should be coordinated with:
- batching time;
- travel time;
- discharge;
- pumping;
- placement.
See Concrete Mix Design Approval and Production Control.
RMC quality should be controlled throughout the complete production-and-delivery process rather than only at the batching plant.
Pumped Concrete in Hot Weather
Hot-weather pumping can become difficult if concrete loses workability before reaching the pump.
Possible effects include:
- increased pump pressure;
- lower pumping rate;
- difficult placing;
- blockage risk.
Uncontrolled additional water should not be used as the solution.
See Pumped Concrete Mix Design.
High-Strength Concrete in Hot Weather
High-strength concrete commonly contains:
- low w/cm;
- high binder content;
- HRWR;
- SCMs.
This can make the mix sensitive to:
- temperature;
- admixture dosage;
- slump retention.
Hot-weather trials are particularly important.
See High Strength Concrete Mix Design.
Self-Compacting Concrete in Hot Weather
SCC relies on adequate flowability while maintaining stability.
Loss of flow with time may affect:
- filling ability;
- passing ability;
- placing through congested reinforcement.
For SCC, slump-flow retention may be more important than conventional slump.
See Self-Compacting Concrete Mix Design.
Plastic Shrinkage in Hot Weather
Plastic shrinkage cracking can develop when water evaporates rapidly from the fresh concrete surface.
Risk increases with the combined effect of:
- high concrete temperature;
- high ambient temperature;
- low relative humidity;
- wind.
Possible controls include:
- reducing concrete temperature;
- windbreaks;
- sunshades;
- prompt finishing;
- early curing;
- suitable evaporation-control procedures where approved.
Importance of Early Curing
Hot weather can cause rapid surface moisture loss.
Therefore, curing should begin as early as practicable after finishing.
Depending on the project, methods may include:
- water curing;
- wet coverings;
- plastic sheeting;
- approved curing compounds.
The selected method should comply with the project specification.
Hot-Weather Production and Placement Workflow
Check Weather Conditions
↓
Measure Material Temperatures
↓
Check Aggregate Moisture
↓
Apply Cooling Measures
↓
Batch Approved Mix
↓
Measure Fresh-Concrete Temperature
↓
Check Initial Workability
↓
Dispatch Without Delay
↓
Monitor Transport Time
↓
Check Workability and Temperature at Site
↓
Place Without Unnecessary Delay
↓
Finish Correctly
↓
Start Curing Early
Hot-Weather Concrete Troubleshooting
| Problem | Possible Cause | Recommended Check |
|---|---|---|
| Rapid slump loss | High concrete temperature | Temperature and admixture |
| Low slump at site | Long transport | Transit time |
| High water demand | Hot materials | Aggregate and water temperature |
| Variable slump | Moisture variation | Moisture correction |
| Fast setting | High temperature | Temperature and admixture |
| Excessive retardation | High admixture dosage | Trial results |
| Segregation | Excessive initial slump | Mix stability |
| High pump pressure | Workability loss | Retention and grading |
| Plastic cracking | Rapid evaporation | Protection and curing |
What to Check Before Changing the Approved Mix
Before modifying an approved concrete mix, check:
- aggregate temperature;
- aggregate moisture;
- cement temperature;
- mixing-water temperature;
- concrete temperature;
- admixture dosage;
- transport time;
- site waiting time;
- plant calibration;
- mixer performance.
See Concrete Batching Plant Calibration.
Common Hot-Weather Concreting Mistakes
Adding Water Automatically
Low site slump does not automatically mean more water is required.
Increasing Initial Slump Excessively
Very high initial slump may increase segregation and bleeding.
Ignoring Aggregate Moisture
Sprinkling aggregate for cooling changes its moisture condition.
Ignoring Concrete Temperature
Ambient temperature alone does not represent the concrete condition.
Using the Same Admixture Dosage in Every Season
Admixture performance can vary with temperature.
Ignoring Transport Time
A mix that performs well after 15 minutes may perform differently after 90 minutes.
Waiting Too Long at Site
Hot concrete can continue to lose workability while waiting for placement.
Delaying Curing
Rapid moisture loss can increase surface cracking risk.
Hot-Weather Concrete Checklist
Before Batching
- Weather conditions checked
- Aggregate temperature checked
- Aggregate moisture checked
- Mixing-water condition checked
- Cooling arrangement ready
- Admixture system approved
- Site readiness confirmed
At the Batching Plant
- Approved mix used
- Moisture correction applied
- Fresh-concrete temperature recorded
- Initial workability checked
- Batch time recorded
- Dispatch started promptly
During Transport
- Transit time monitored
- Unnecessary waiting avoided
- Mixer operated according to approved procedure
At Site
- Arrival time recorded
- Concrete temperature checked where required
- Slump/workability checked
- Uncontrolled water not added
- Placement started promptly
- Curing arrangement ready
Frequently Asked Questions
What Is Hot-Weather Concreting?
Hot-weather concreting is the production and placement of concrete under environmental conditions that may adversely affect fresh or hardened concrete.
Which Indian Standard Covers Hot-Weather Concreting?
IS 7861 (Part 1):1975 provides recommended practice for hot-weather concreting in India.
What Is the Concrete Temperature Limit as per IS 7861?
IS 7861 recommends cooling the ingredients where necessary so that concrete temperature at the time of placing is below 40°C.
Project specifications may require a lower temperature.
Is 40°C the Maximum Temperature for Every Project?
No.
Major infrastructure, bridge, metro or special concrete specifications may require stricter limits.
The stricter applicable requirement should be followed.
Can Water Be Added to Hot Concrete to Restore Slump?
Uncontrolled water addition should not be used as a routine method of restoring workability because it can increase the water-cement ratio.
Can Ice Be Used in Concrete?
Yes, where technically planned.
The ice should be treated as part of the total mixing water and should melt completely during mixing.
Why Are Aggregates Important in Temperature Control?
Aggregates normally make up most of the concrete mass and therefore have a major influence on fresh-concrete temperature.
Can Aggregate Be Sprinkled With Water?
Aggregate may be cooled by controlled sprinkling where appropriate, but its changed moisture content must be included in the water correction.
Which Admixture Is Best for Hot Weather?
There is no universal admixture that is best for every hot-weather mix.
The admixture should be selected through compatibility and slump-retention trials using the actual project materials.
Does Hot Weather Increase Slump Loss?
Higher concrete temperature generally increases the risk of rapid workability loss.
Should Slump Be Checked Only at the Batching Plant?
No.
Workability should also be verified at the applicable site acceptance point and time.
Can Hot Weather Affect Concrete Strength?
Yes.
High temperature combined with uncontrolled water addition, rapid setting or inadequate curing can adversely affect concrete performance.
Is Hot-Weather Concrete a Separate Mix Grade?
No.
The specified concrete grade normally remains unchanged. The mix and production process are optimized to maintain required performance under hot-weather conditions.
Related Articles
Concrete Temperature Control at Batching Plant
Moisture Correction in Concrete Mix Design
Superplasticizer in Concrete Mix Design
Cement–Admixture Compatibility in Concrete Mix Design
Water–Cement Ratio in Concrete
High Strength Concrete Mix Design
Self-Compacting Concrete Mix Design
Concrete Batching Plant Calibration
Concrete Mix Design Approval and Production Control
Concrete Mix Design Troubleshooting
Conclusion
Hot-weather concrete performance depends on much more than ambient temperature.
A reliable hot-weather concreting strategy should control:
Materials + Water + Temperature + Moisture + Admixture + Transport + Placement + Curing
The most important practical rules are:
Hot Weather ≠ Add More Water
Ambient Temperature ≠ Concrete Temperature
High Initial Slump ≠ Good Slump Retention
Aggregate Cooling Requires Moisture Correction
Ice Is Part of the Mixing Water
Plant Workability ≠ Placement Workability
Approved Mix + Temperature Control + Slump Retention + Early Curing = Reliable Hot-Weather Concrete
For important pours, hot-weather performance should be confirmed through trials using actual project materials and representative transport and placement conditions.
